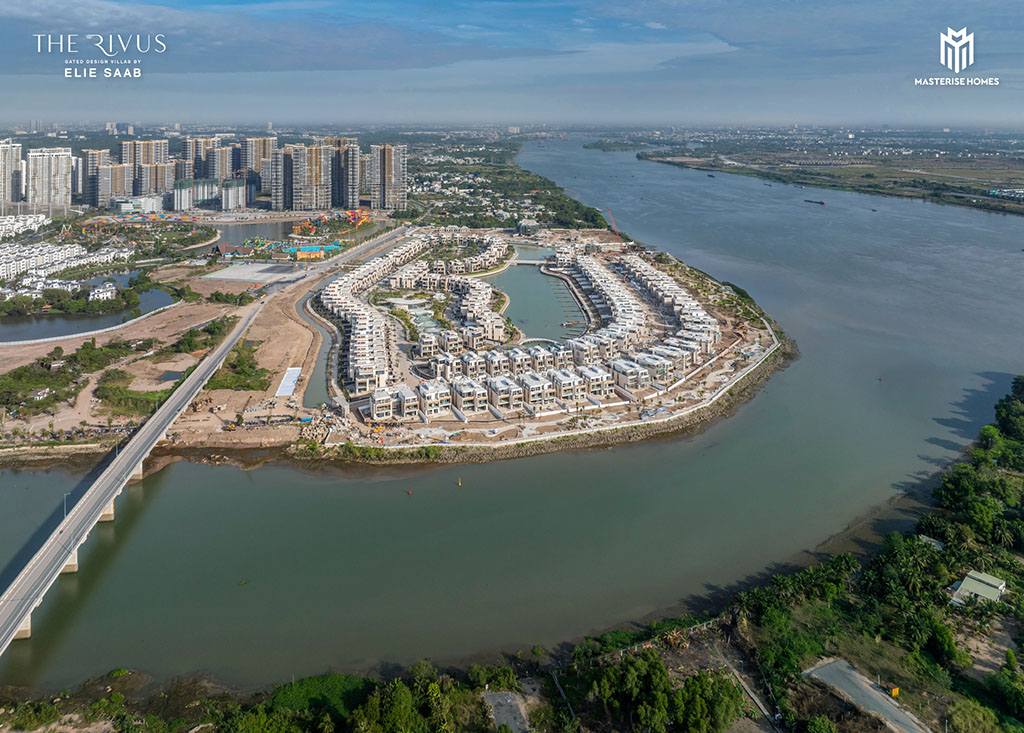

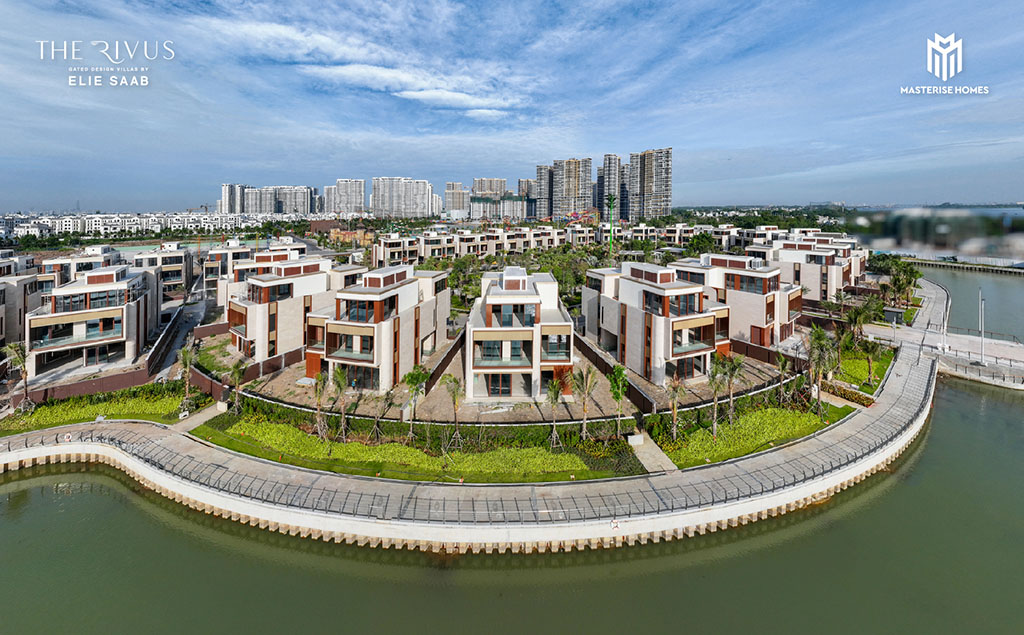

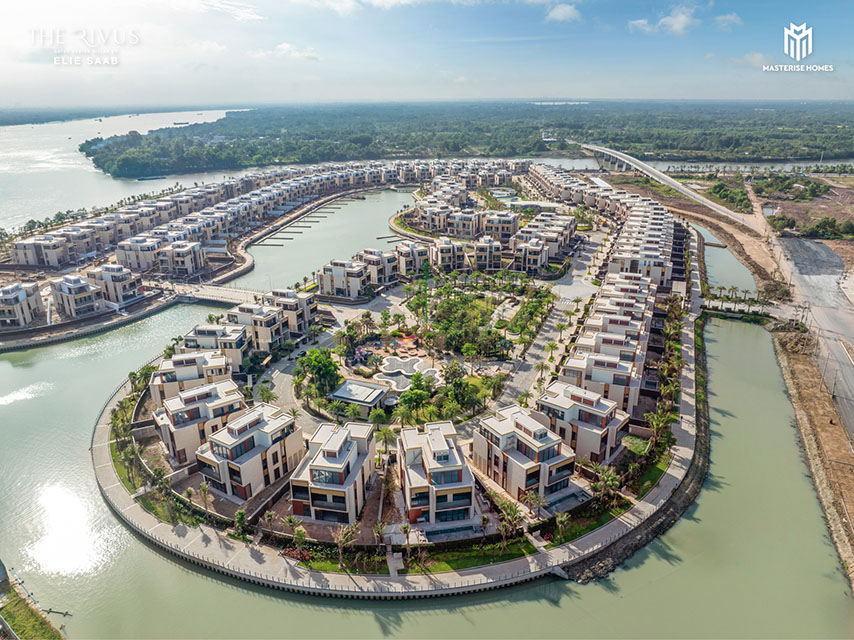

As of early February 2025, the construction of The Rivus residence is still progressing smoothly, ensuring quality and on schedule as planned. With a professional working spirit and high responsibility, the Masterise Homes team and its partners constantly strive to bring a classy living space to future residents. Let’s take a look at the outstanding information about the construction progress of The Rivus:

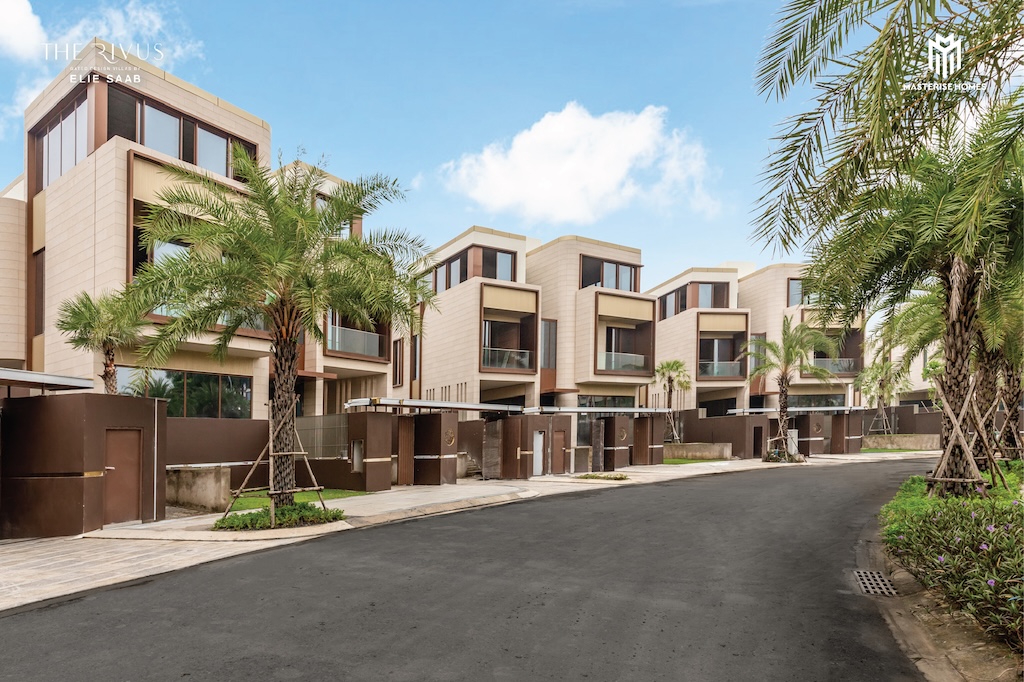

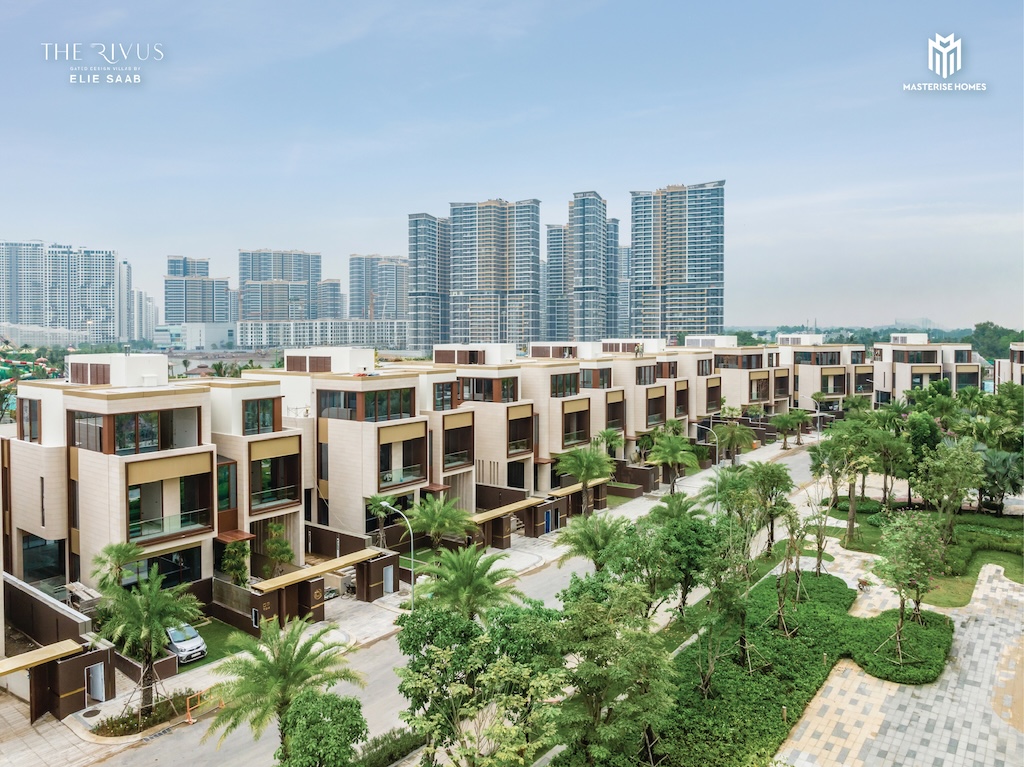

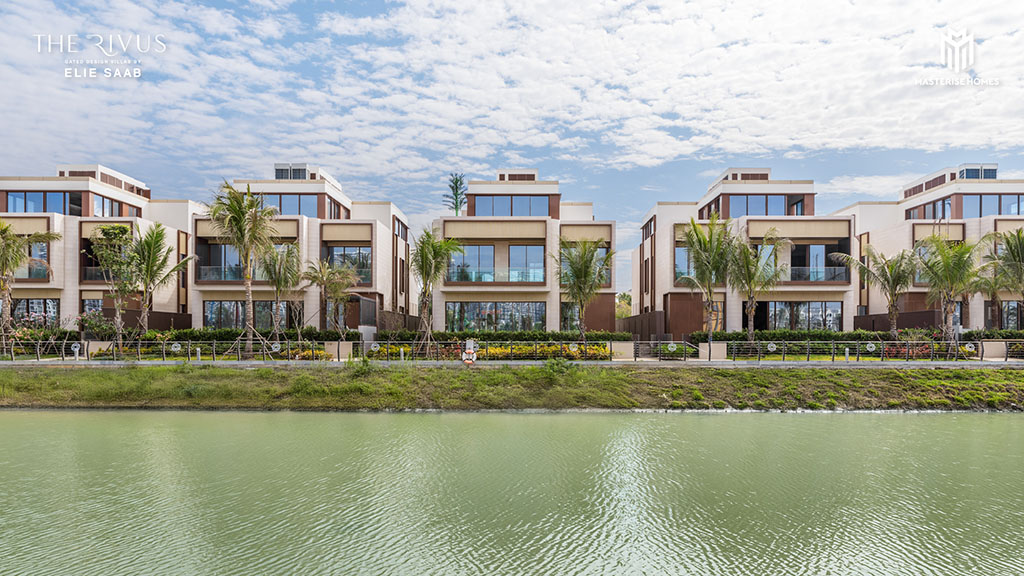

🔸 31 villas in SAVA subdivision: 100% completed exterior architecture, ready to welcome residents.
🔸 The remaining mansions: 95% of the architectural volume of phase 2’s exterior has been completed and 75% of the volume of phase 3 has been completed.
🔸 Lift bridge: More than 98% of the construction volume has been completed and will continue to be tested in January 2025.
🔸 Children’s park: Complete 100% of hardscape and trees, creating a safe, green play space for children.
🔸 Central Park: Achieve 90% of hard landscape volume and continue to plant trees to complete the relaxation space for residents.

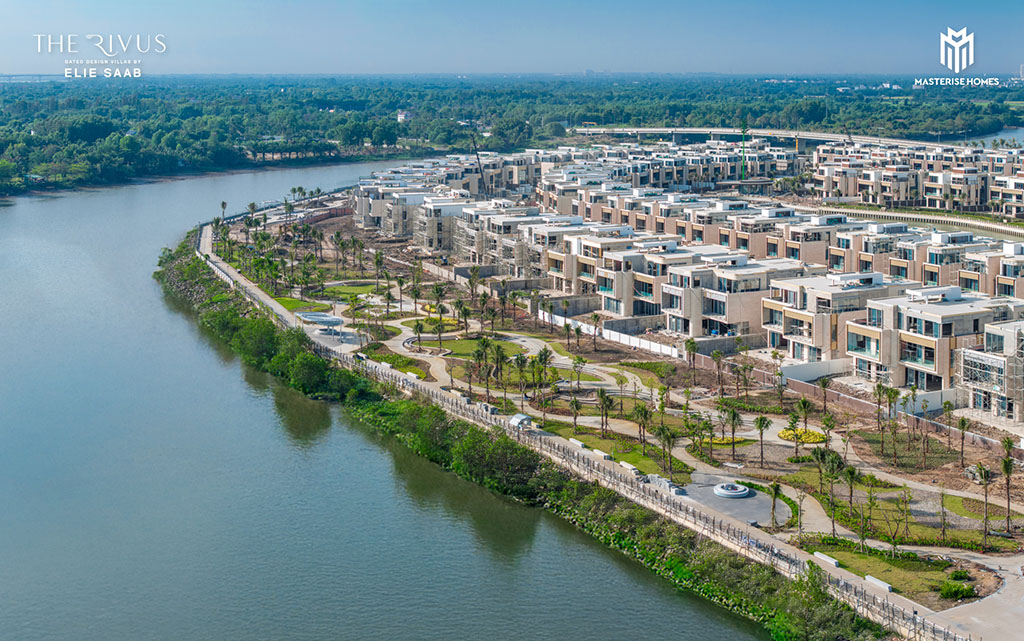

🔸 Riverside Park: 90% of hard landscaping completed and 60% of large trees planted in phases 1 and 2, promising a wonderful green space by the river.
🔸 Internal asphalt road infrastructure: Achieved 100% completion of asphalt carpet and stone paving in phase 1; Currently, construction is continuing and completing phases 2 and 3.
🔸 External infrastructure: Asphalt carpet from Phuoc Thien street to Gate 1 of the project has been completed; It is expected that by the end of March 2025, the entire Phuoc Thien street will be completed, creating a synchronous and spacious infrastructure for the entire area.
In addition to accelerating construction progress, the green landscape areas at The Rivus are also always carefully invested and cared for. Construction activities are accelerating to complete all items, providing classy green space, ready for handover to future residents.

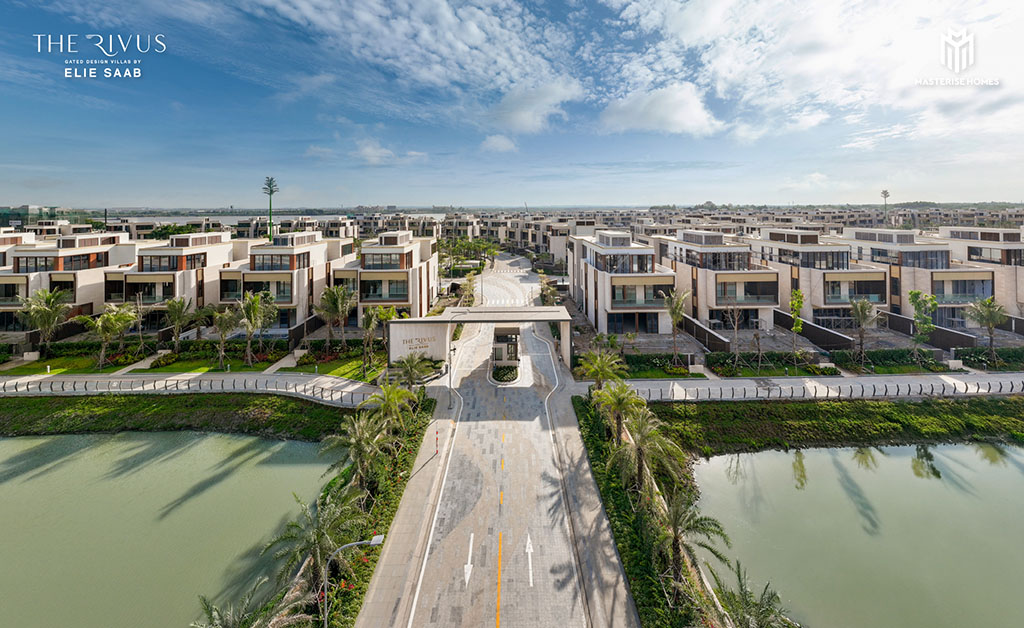

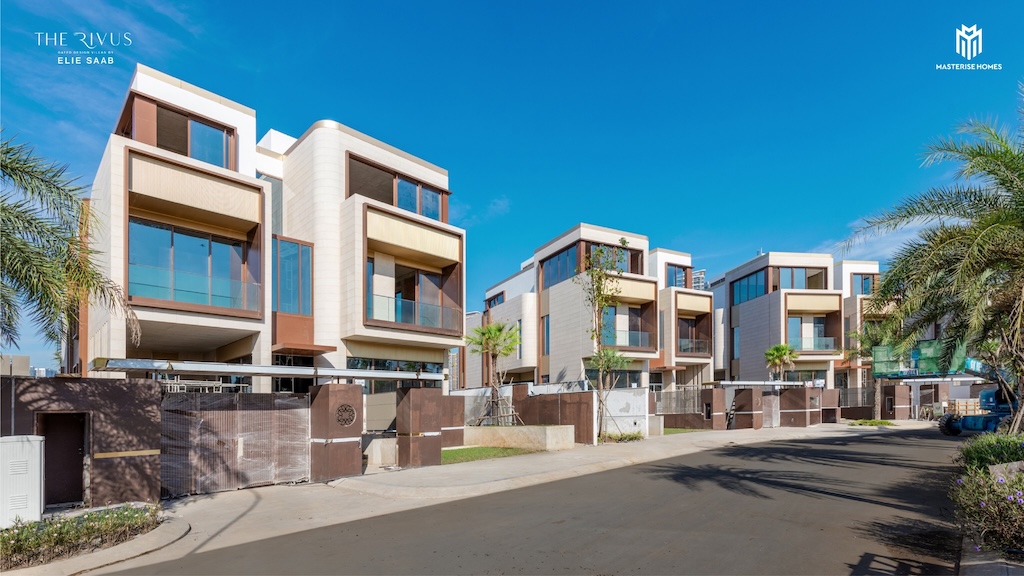

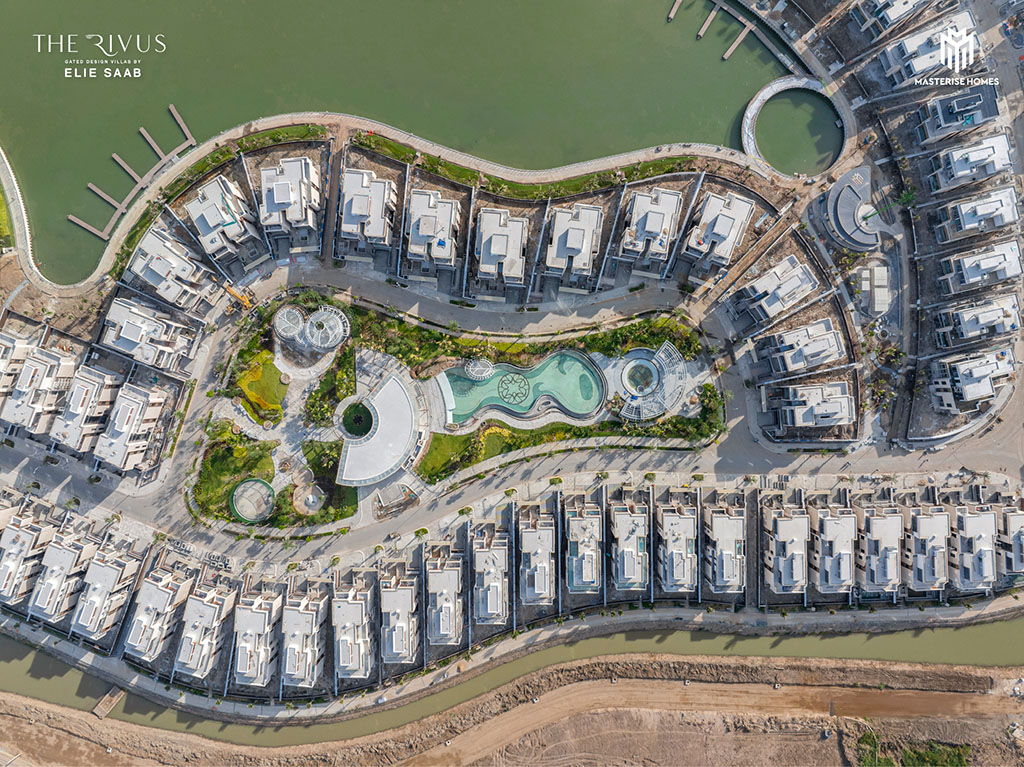

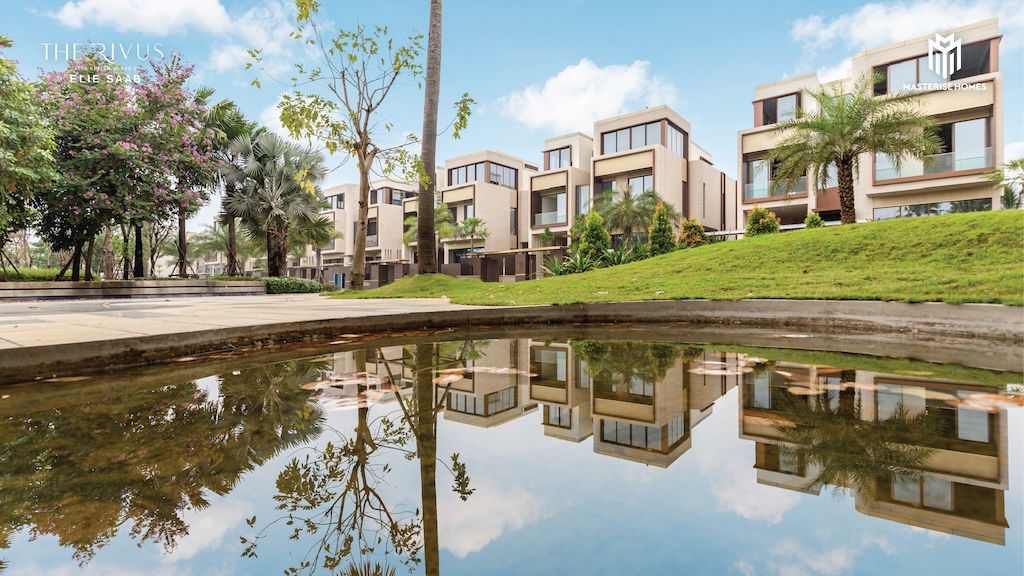

Let’s admire the latest progress images of The Rivus and feel the difference that this luxury residence brings!
